Case Study

A Community-Driven Island Microgrid

Cascadia Renewables

Project Highlights

Location

Eastsound, WA


System Specs

100 kW roof- and ground-mounted PV arrays
1,376 kWh energy storage system


Equipment

PV Modules: Heliene 144HC M10 NTP SL 580
PV String Inverters: SolarEdge SE100KUS
Battery: ELM MG2-ESS-688
Battery Inverter: EPC Power CAB1000

Video credit: Cascadia Renewables
Map showing Orcas Island location in the San Juan Islands of Washington
The Orcas Center sits in the middle of Orcas Island, part of the San Juan Islands archipelago off the Washington State mainland. One of the northernmost parts of the continental U.S., Orcas Island is roughly three hours (by car and ferry) from downtown Seattle.

Challenge

Powered by a single undersea transmission line and accessible only by ferry or small plane, Orcas Island is uniquely vulnerable to disruption. In the event of an earthquake, wildfire, or severe weather, residents could be cut off from critical supplies and services for days.

The San Juan County Emergency Management (SJCEM) agency identified the Orcas Center as a facility that could function as a critical emergency support hub if reliable backup power could be installed. At the time, however, the Center had no energy resilience infrastructure. A prolonged outage would leave it dark and inaccessible just when the island needed it most.

Recognizing this gap, SJCEM began exploring options for a solar- and battery-based microgrid system that could keep essential services online during emergencies while reducing operating costs under normal conditions.

In other words, this island facility was interested in “islanding” from the grid.

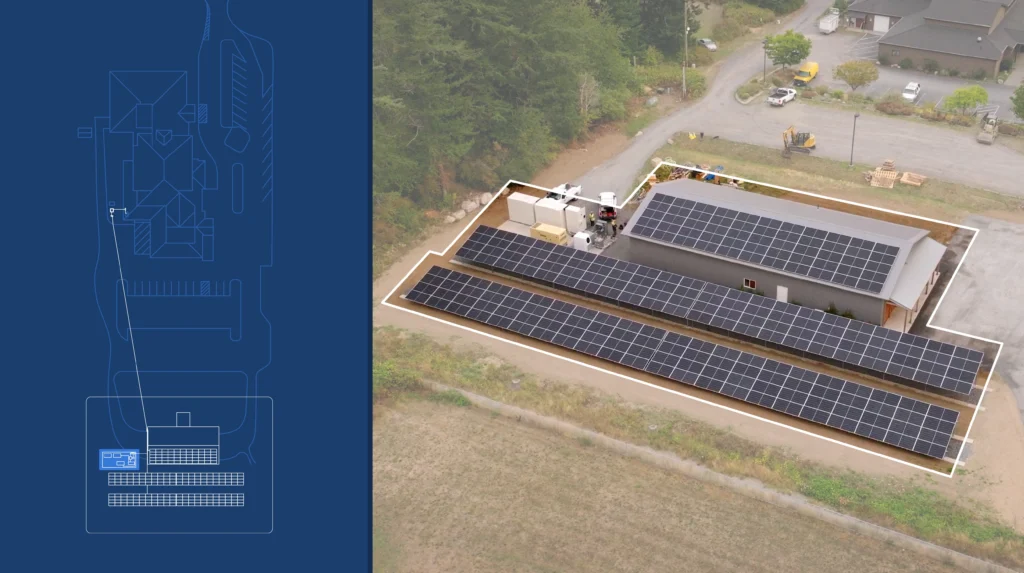

Left: the Orcas Center site plan, showing microgrid equipment to the south and trenched conduit to the point of interconnection at the southwest corner of the facility. Right: the installed system, including rooftop and ground-mount PV arrays, and pad-mounted BESS and generator.

Approach

Based in Bellingham, Washington and with a history of Pacific Northwest community-led microgrid development, Cascadia Renewables was selected as the EPC for the Orcas Center project. Cascadia worked with local partners from MZ Solar Consulting to perform preliminary analyses and Mayfield Renewables to lead planset development and to act as the electrical engineer of record.

By the time Mayfield became involved, Cascadia had already defined performance goals for the microgrid, and MZ had estimated the distributed energy resource (DER) sizes required to meet those goals. Mayfield validated the initial design for code compliance, worked with the Orcas Center and the local AHJ to determine equipment locations, and defined roles and responsibilities to fulfill the complex system controls functions.

Project Hurdles

There’s something to learn from every microgrid project, and the Orcas Center was no exception. We took away a few key insights:

Quality load analysis = more confident assumptions

We had to downsize the main breaker from 2000AF/1600AT to a 1200A, three-pole motorized breaker to enable islanding functionality and connect on the load side of the main switchboard. Luckily, we had access to 15-minute interval data from the utility. Working with MZ Solar Consulting, we re-ran load analyses to confirm the downsized breaker would be sufficient to power existing loads.

This is not always the case! Often, we have limited load data to work with and have to adjust our calculations and assumptions accordingly. Best practice for microgrid resource sizing is to obtain as high quality, high resolution data as possible by gathering utility interval data or installing meters onsite to perform a load study.

Start your sequence of operations planning early

The Orcas Center microgrid relied on two separate relays and motorized breakers to coordinate solar PV, battery energy storage system (BESS), and generator dispatch: The primary relay in the main switchboard islands the microgrid when it senses a grid outage. The secondary relay on the generator pad senses when the PV and BESS can no longer meet facility loads, or when the BESS falls below a programmed state of charge, turning on the generator in either scenario.

Accomplishing this level of controls coordination is not a simple task. For this project, we had to align all stakeholders on the project goals to aid in relay selection. Best practice is to assign controls-related roles and responsibilities as early as possible in a project by collaborating with the system owner, the developer, the electrical engineer of record, and the controls provider.

Know your fire code

The Orcas Center had limited space to work with, and wanted to colocate all microgrid equipment at the south end of the property for ease of installation and maintenance. Local zoning ordinance required an extended 20 ft setback from adjacent property lines, and the desired equipment area was surrounded with trees and shrubs, which presented a fire hazard. We ended up clearing vegetation and following equipment spacing requirements to size and locate the pad – maximizing the amount of available space for equipment while satisfying the fire marshal.

Best practice here is, as always, to work closely with your AHJ and fire marshal to determine their BESS size and setback requirements. If you’re looking to brush up on fire code, consider registering for one of our self-paced online courses or check out our free Code Corner series on YouTube.

Result

Today, Orcas Center functions as a dual-purpose hub—supporting arts and culture under normal conditions and providing essential services during grid disruptions. Its small-footprint design offers a template for other community facilities across the country.

Mayfield and Cascadia Renewables’ feasibility-first, stakeholder-informed, technically grounded approach demonstrates how thoughtful engineering can deliver measurable resilience. The group arrived at the following system configuration, which offsets approximately 87% of the Orcas Center’s annual energy use:

In a grid outage, the microgrid system can:

  • Operate independently for up to 56 hours in the winter without generator support
  • Maintain continuous autonomy in the summer through solar charging
  • Maintain continuous emergency operation through the winter with 33–56 additional hours of generator runtime (70% reduction over the generator-only scenario)

The ELM energy storage system also enabled value stacking, going beyond resilience to provide demand charge reduction and energy arbitrage when connected to the grid.

System block diagram under normal, grid-tied operations with the generator disconnected and ample solar and BESS resource
The primary relay detects a grid outage, opens the motorized breaker to island from the grid, and triggers the BESS inverter to enter grid-forming mode within 100 ms. In this example, the sun is out and the BESS is at a relatively high state of charge so the generator remains disconnected.
The sun has set, and the BESS is running low on charge, so the BMS triggers the second motorized breaker to close once the generator frequency is synchronized. The generator becomes the primary power source and recharges the BESS.
